125 Bank Street – June Update 2022
I’m pleased to report that good progress was made during June with the following works either completed or commenced:
Villas 1 to 4:

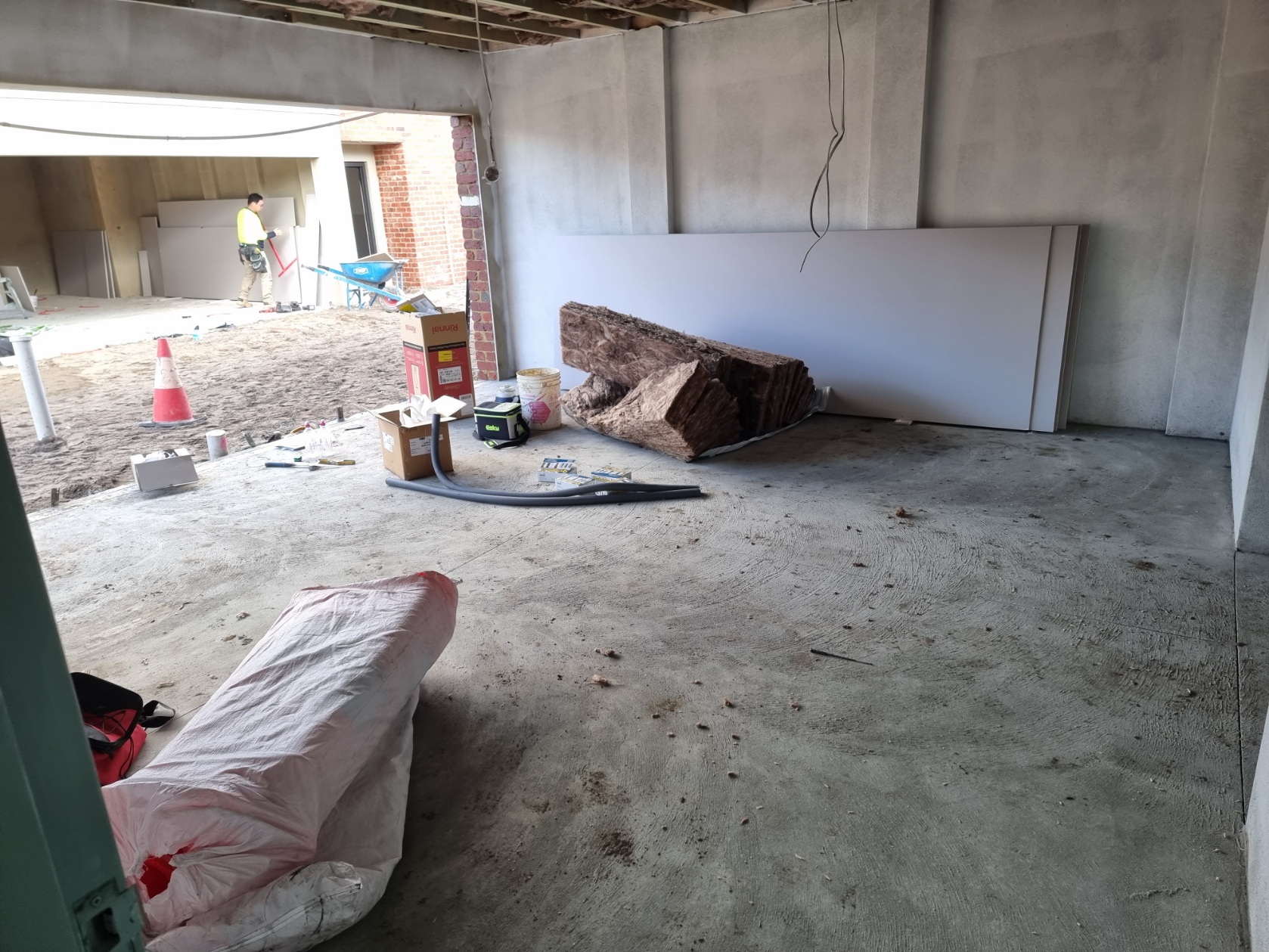

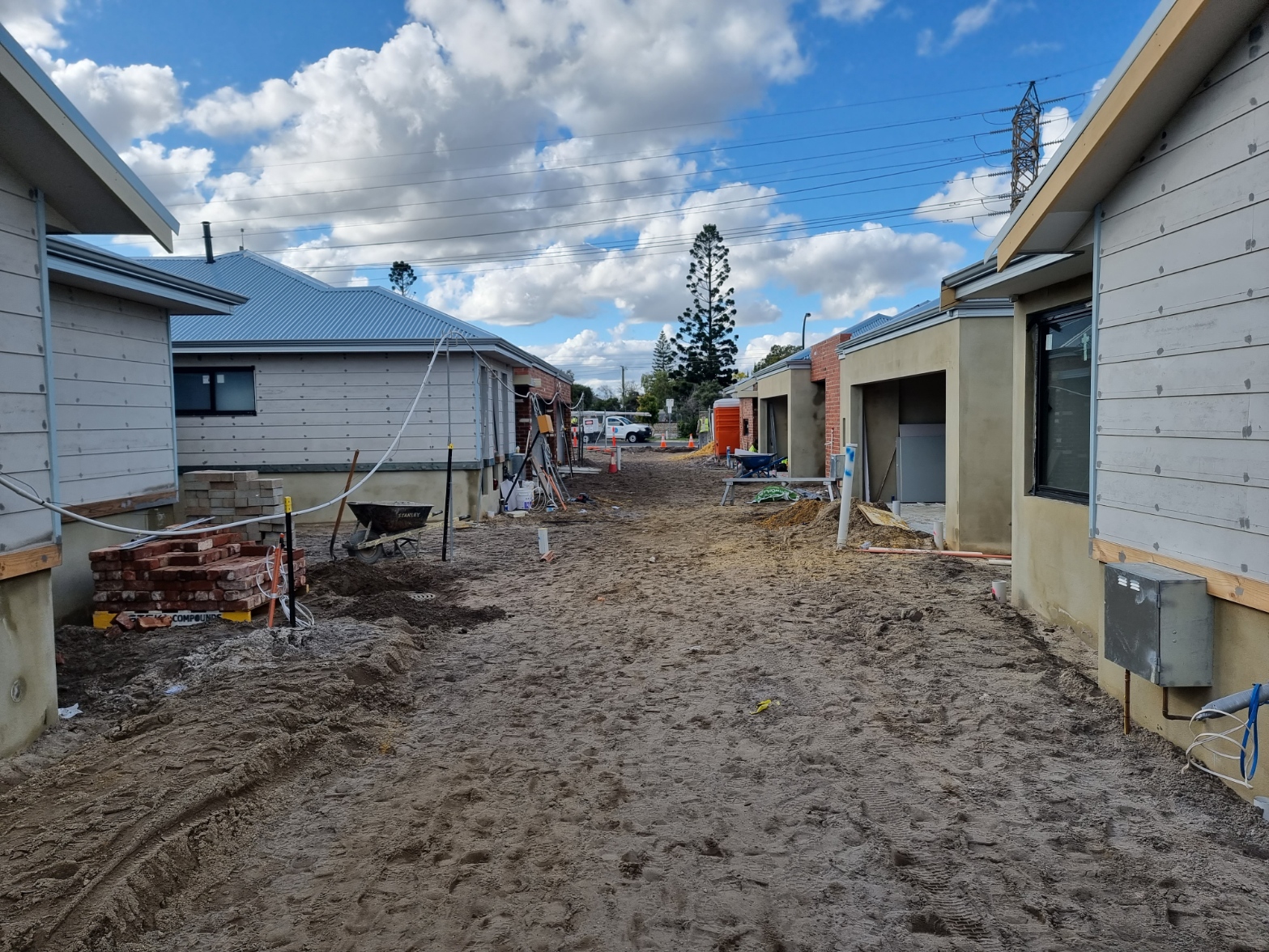

- Roof cover was completed on villas 1 and 3.

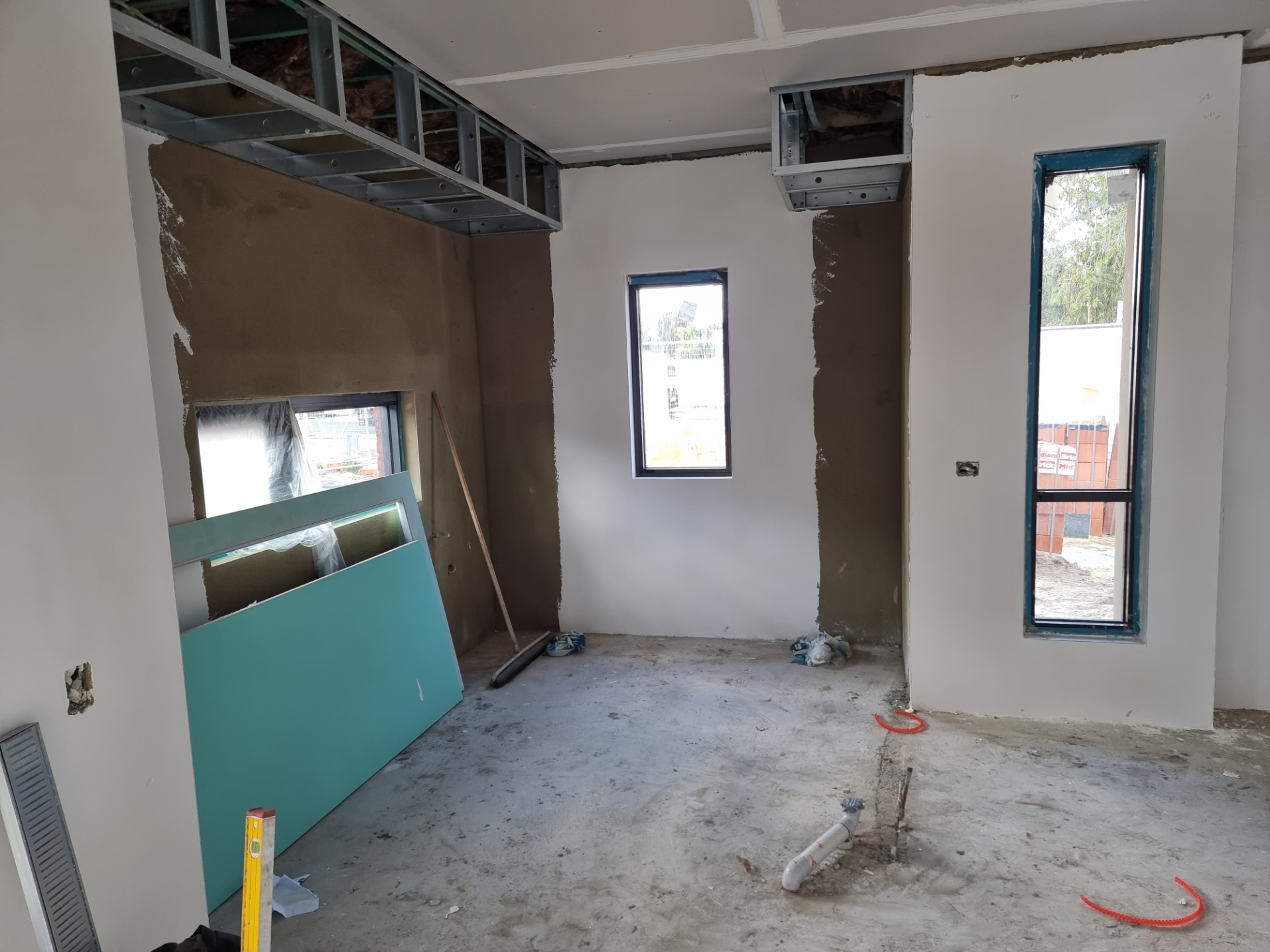

- The white set has been applied to the internal walls of all four villas.

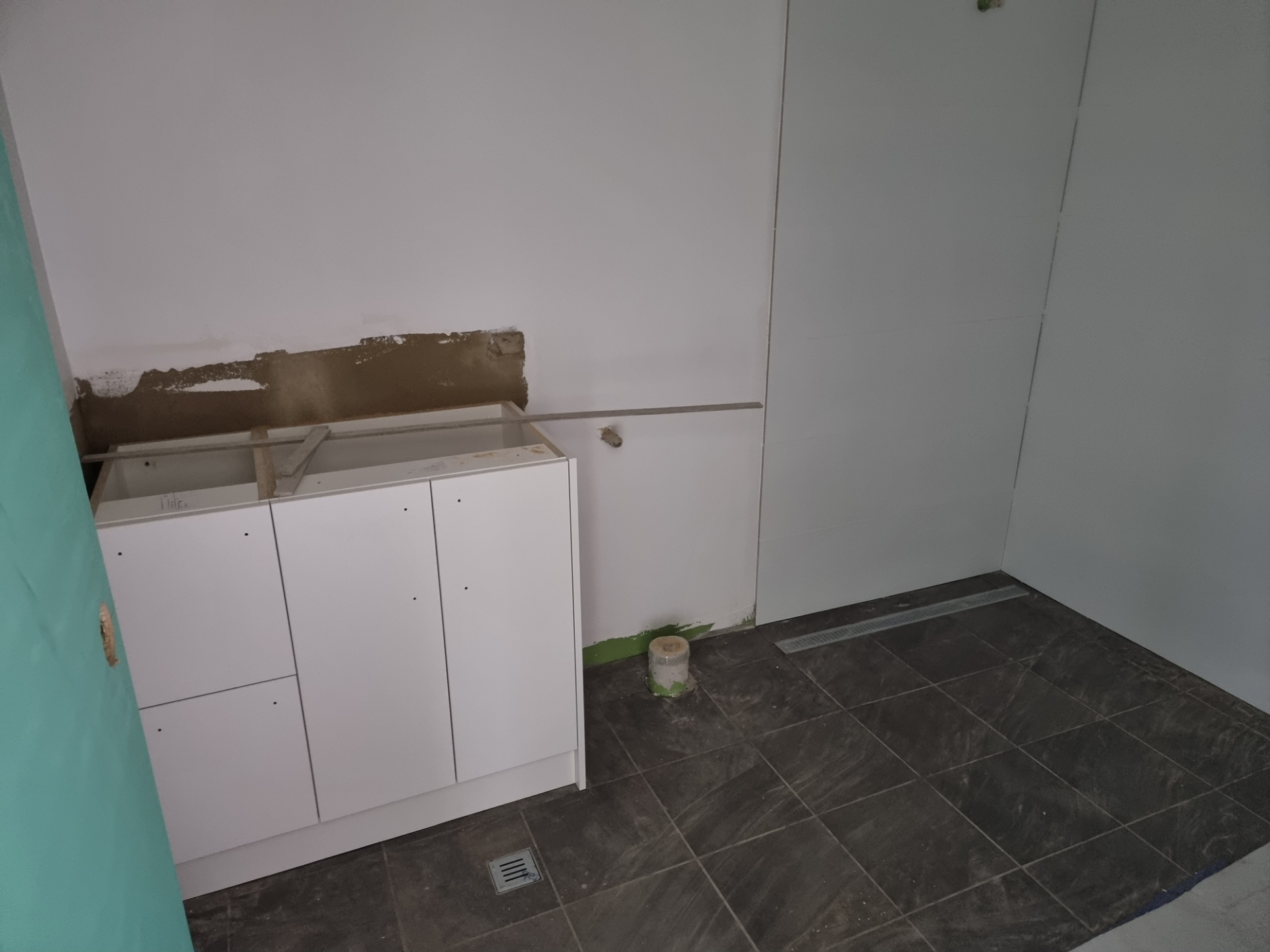

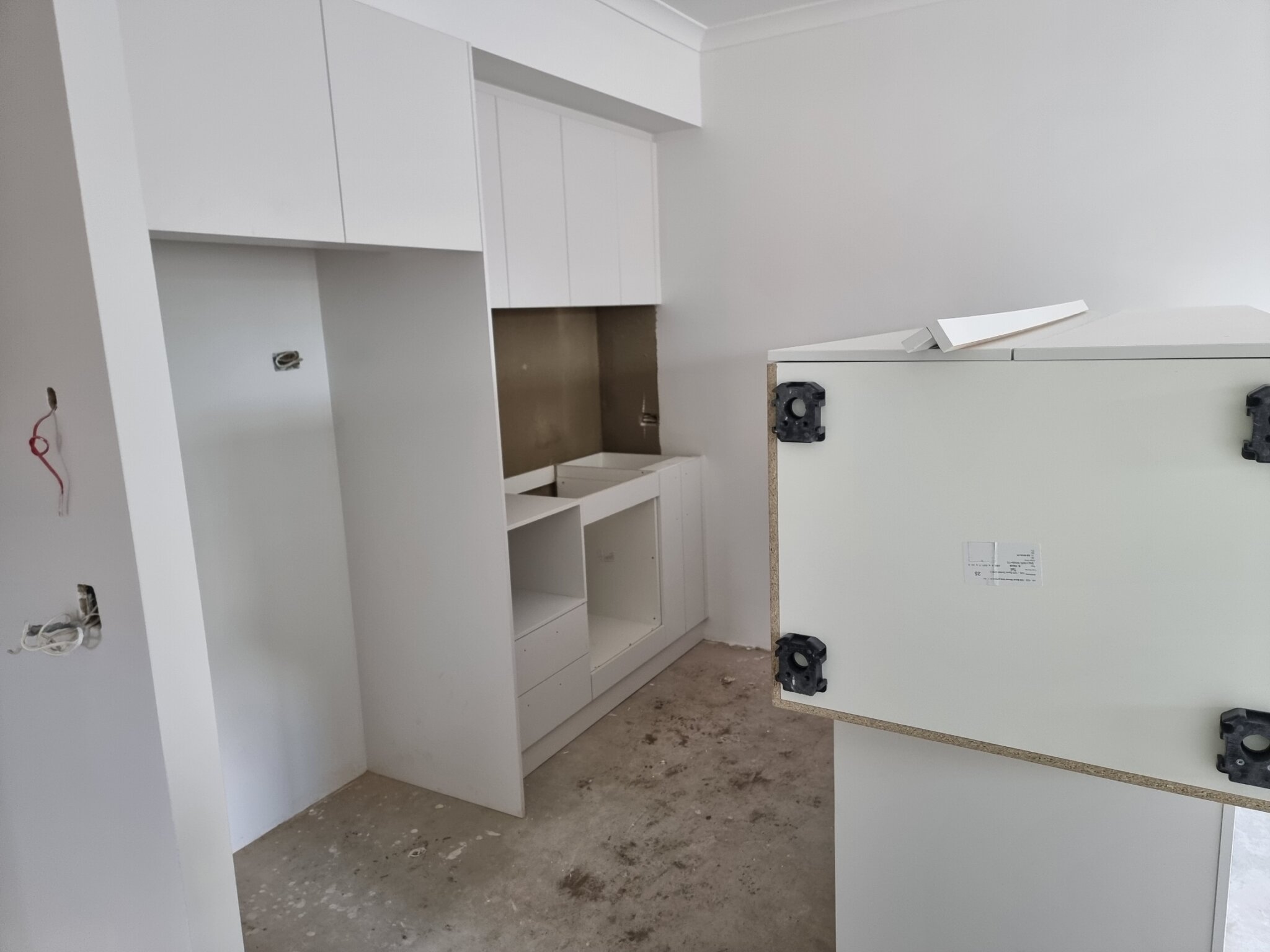

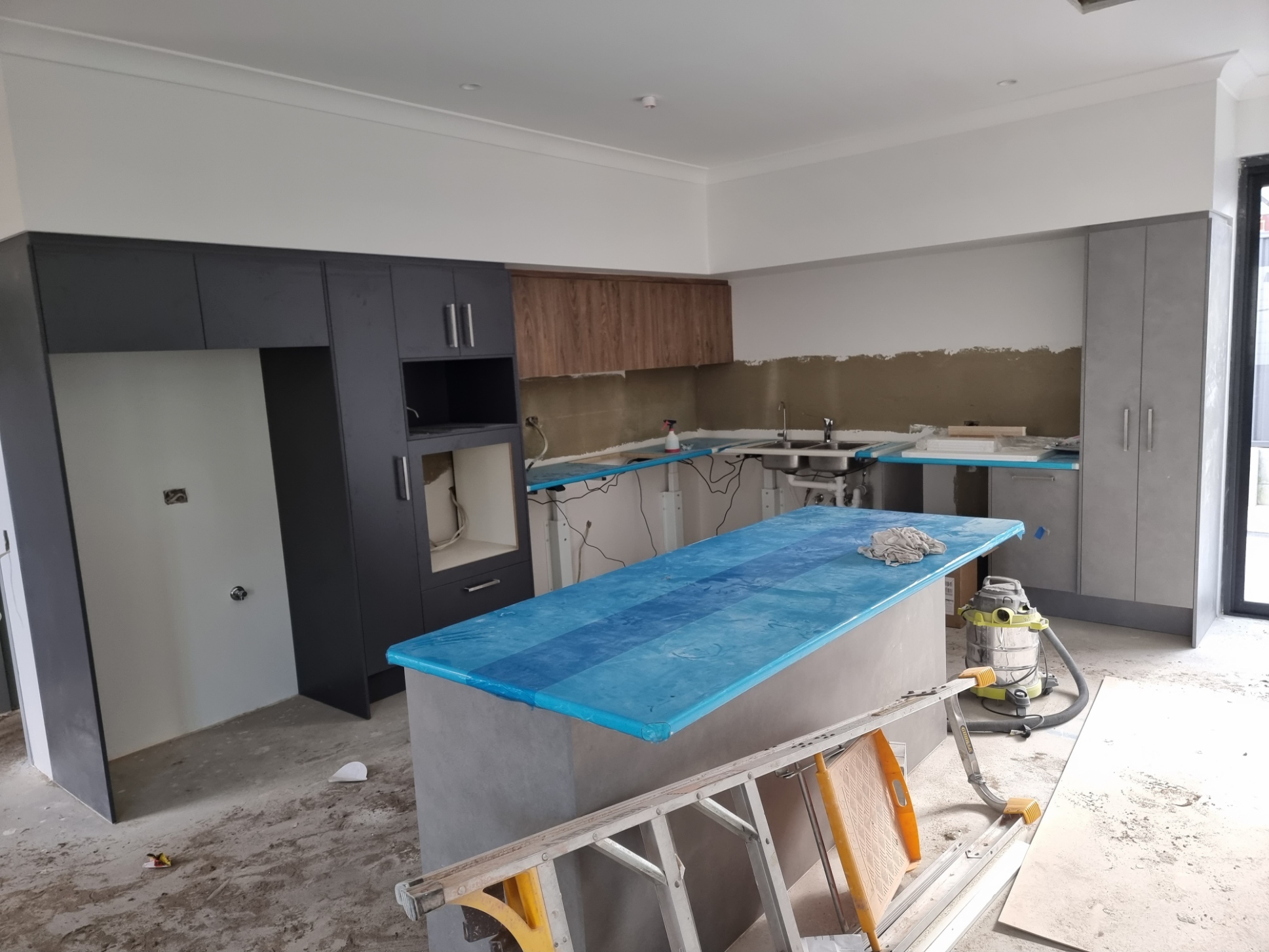

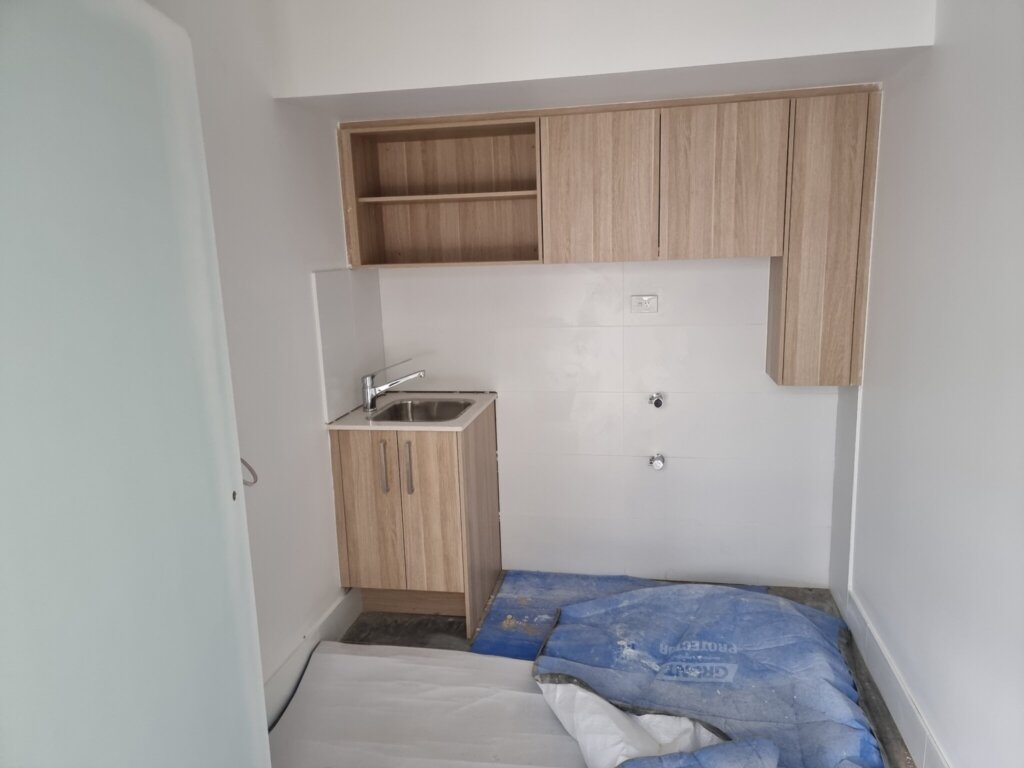

- The installation of the cabinetry has commenced in villa 1.

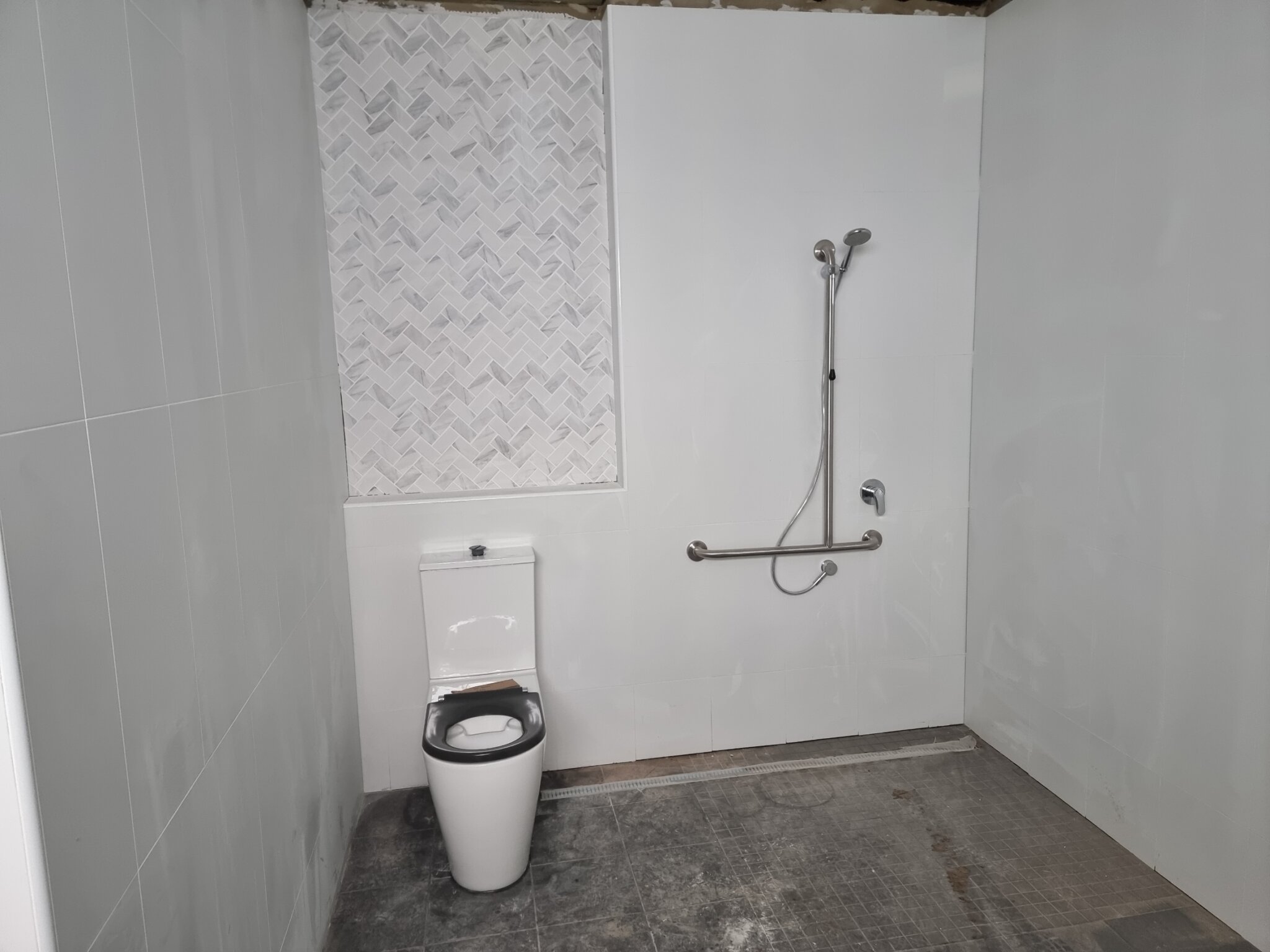

- Tiling of the wet areas has commenced.
- The garage floors in all four villas were poured.

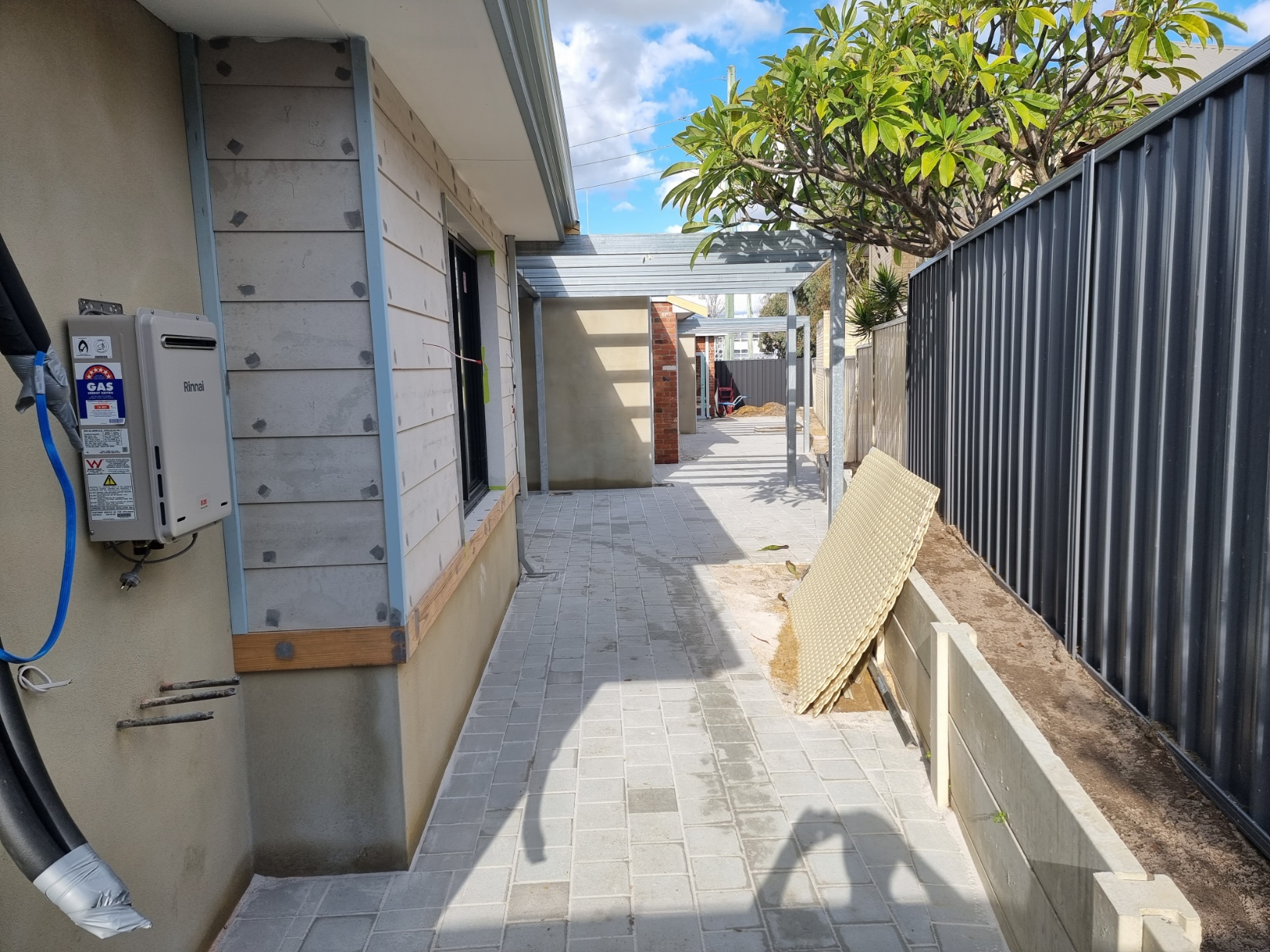

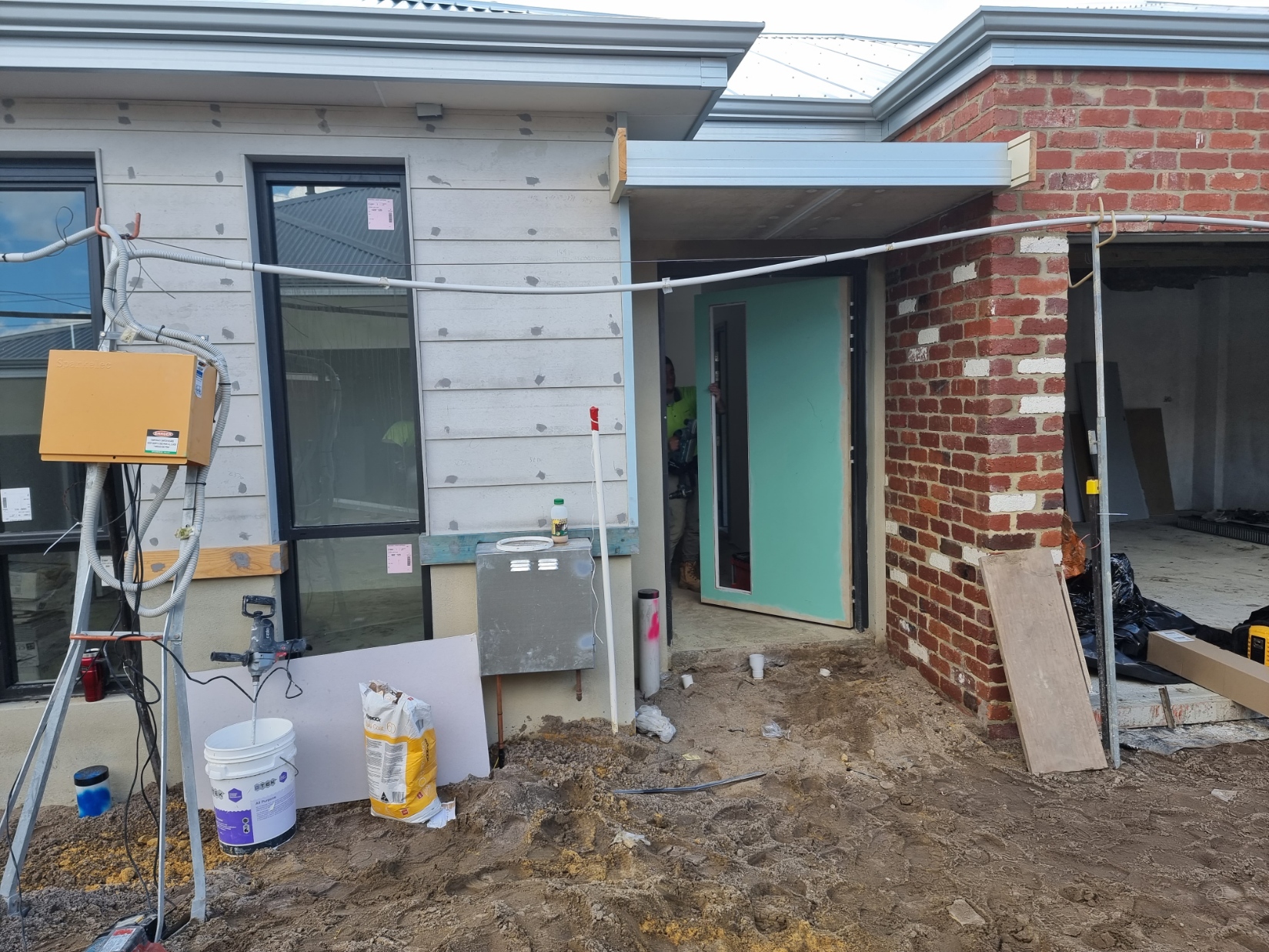

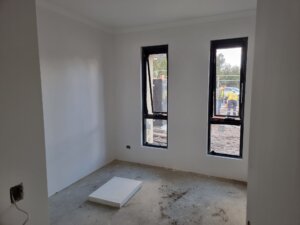

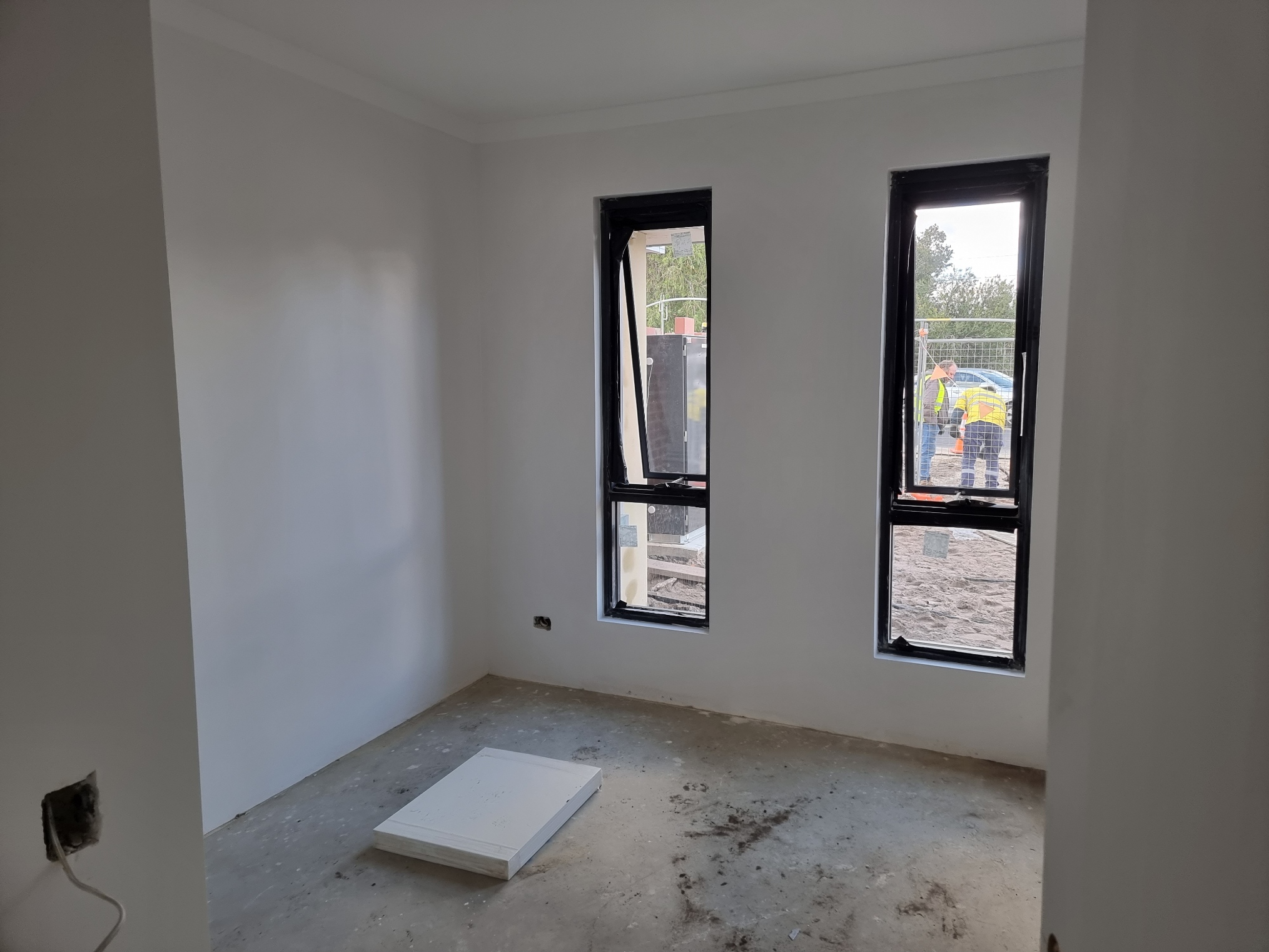

- Hanging of the front doors has commenced which will allow lockup to be achieved.

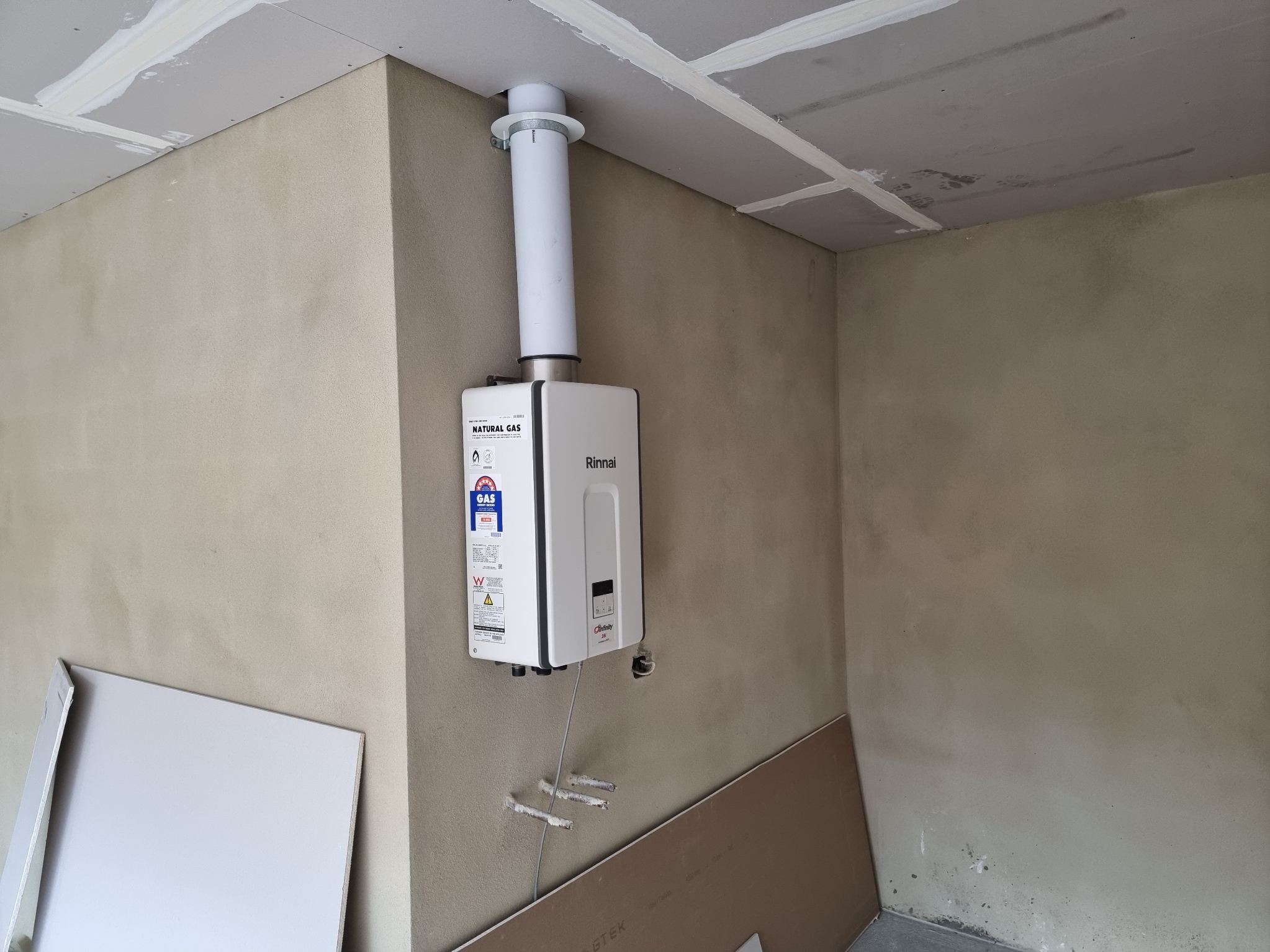

- The hot water systems were installed.
Villas 5 to 8:

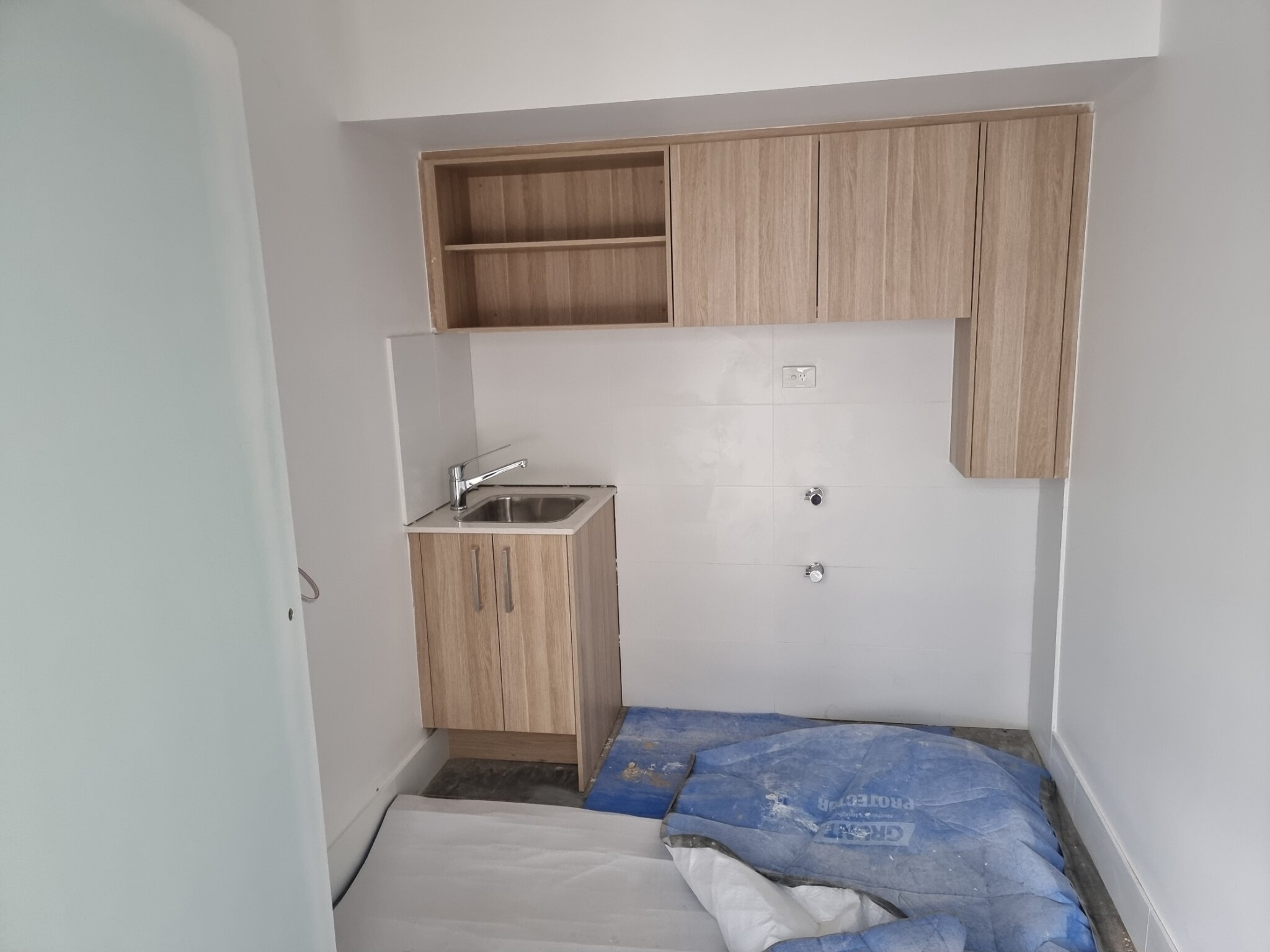

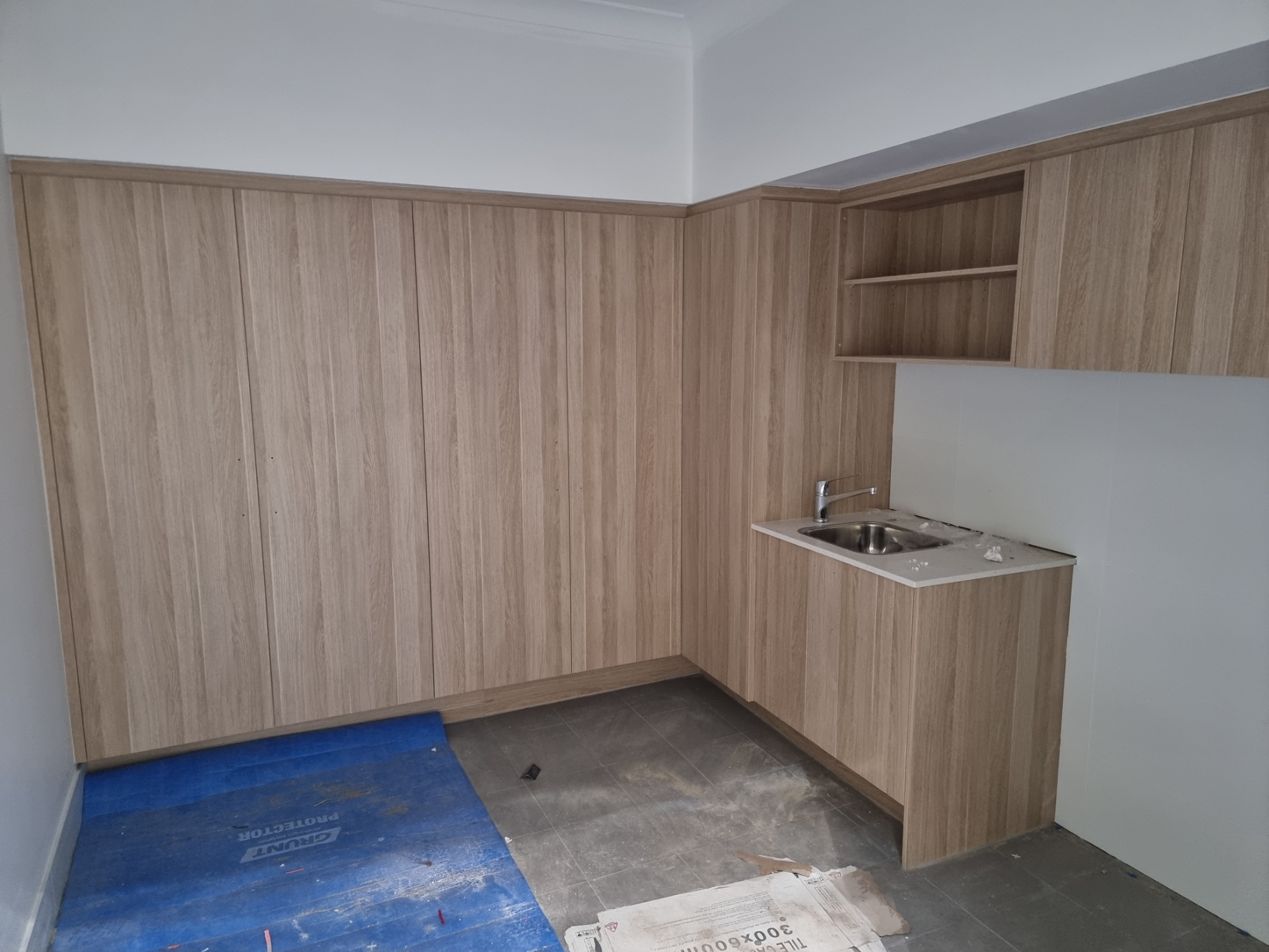

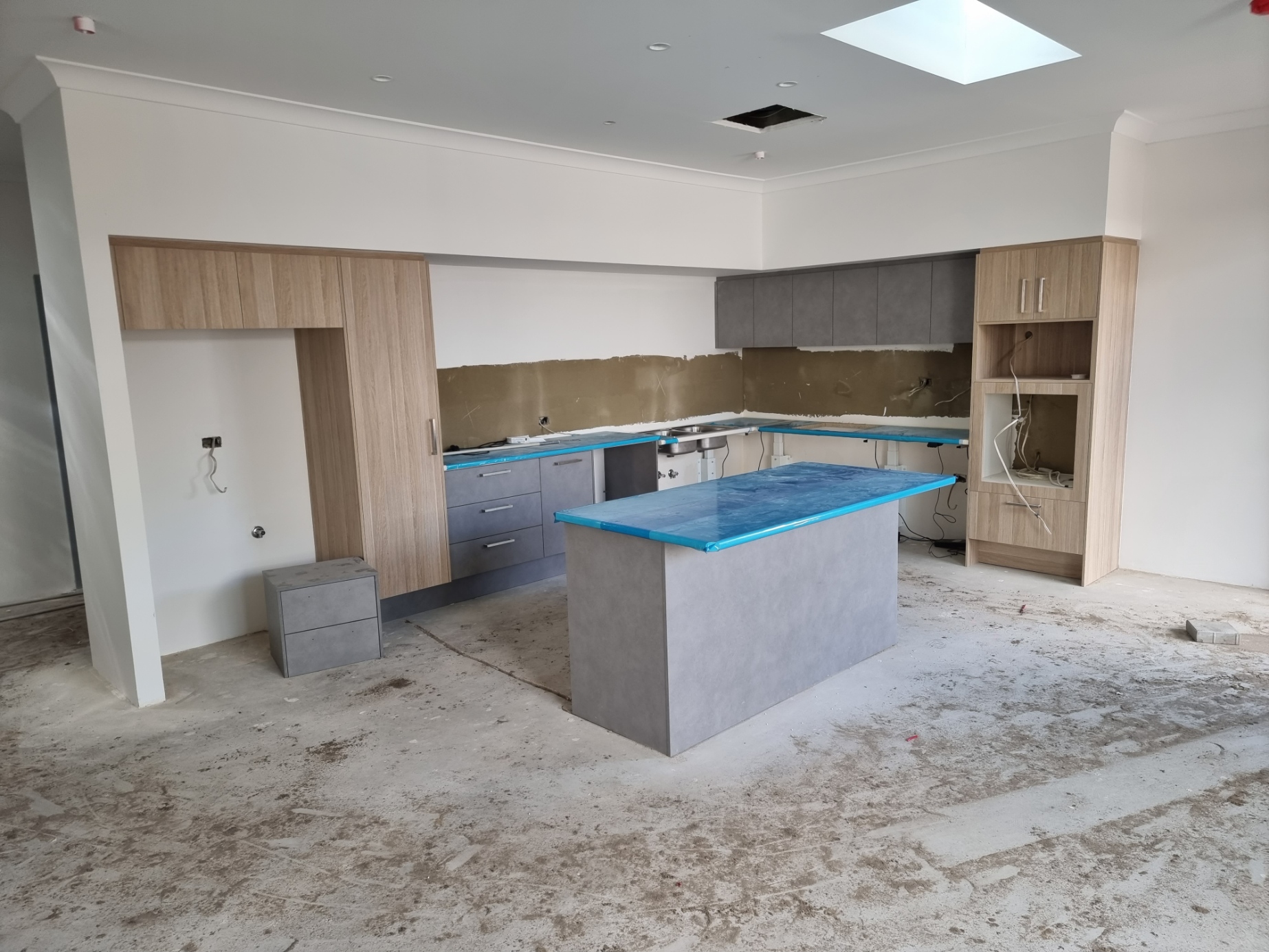

- All of the cabinetry has been installed, with only a few minor items still outstanding.
- All of the courtyards have been paved.
- All of the tiling has been completed.
- The hot water systems were installed.
- The electrical distribution boards were installed.
The builder is aiming to achieve practical completion on villas 5 to 8 by the middle of July and villas 1 to 4 by the middle of August.
The staggered practical completion will allow Rocky Bay to access villas 5 to 8 and commence their fitout which is scheduled to take 4 weeks. This will then allow the entire site to be completed by the middle of August.
I look forward to updating you next month, but in the meantime should you have any queries please feel free to contact me on (08) 6144 0700 or 0451 533 440.
Regards,
Travis McKenzie
