125 Bank Street – March Update 2022

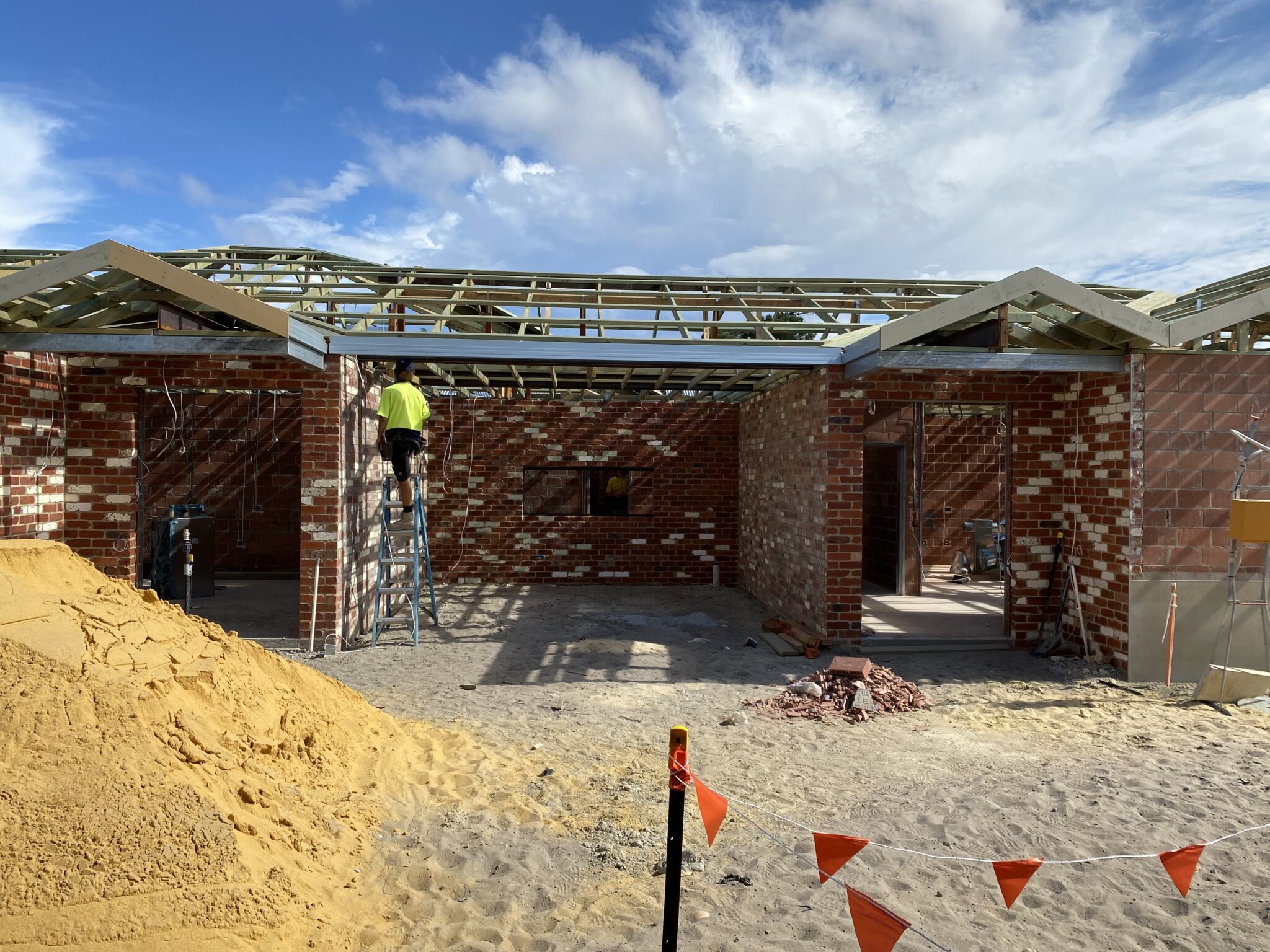

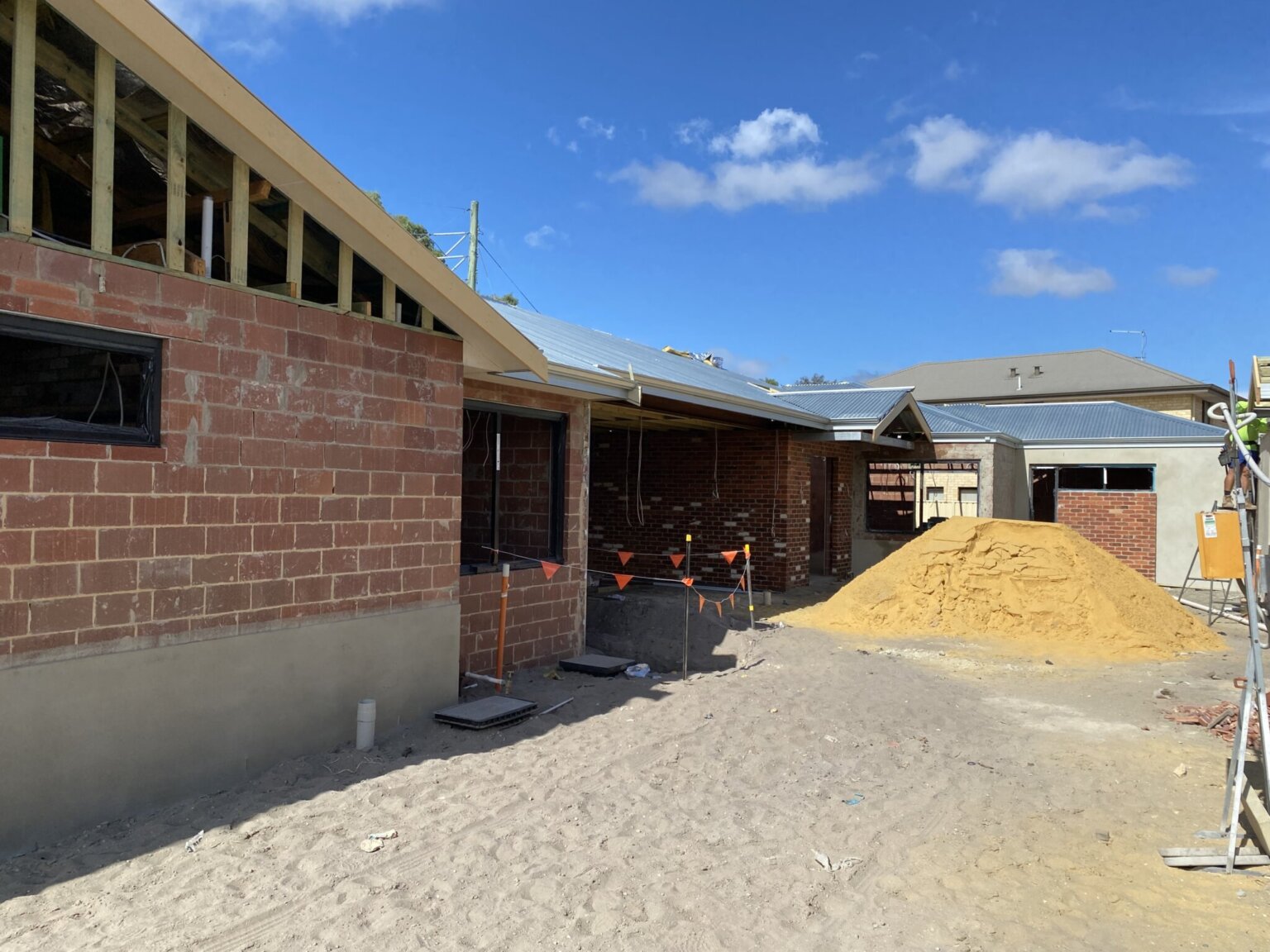

Six of the eight villas now have their roof framing complete, with only villas 1 and 3 remaining. With the roof framing complete this has allowed villas 5 and 7 to have their roof sheeted, with villas 6 and 8 to be sheeted next.

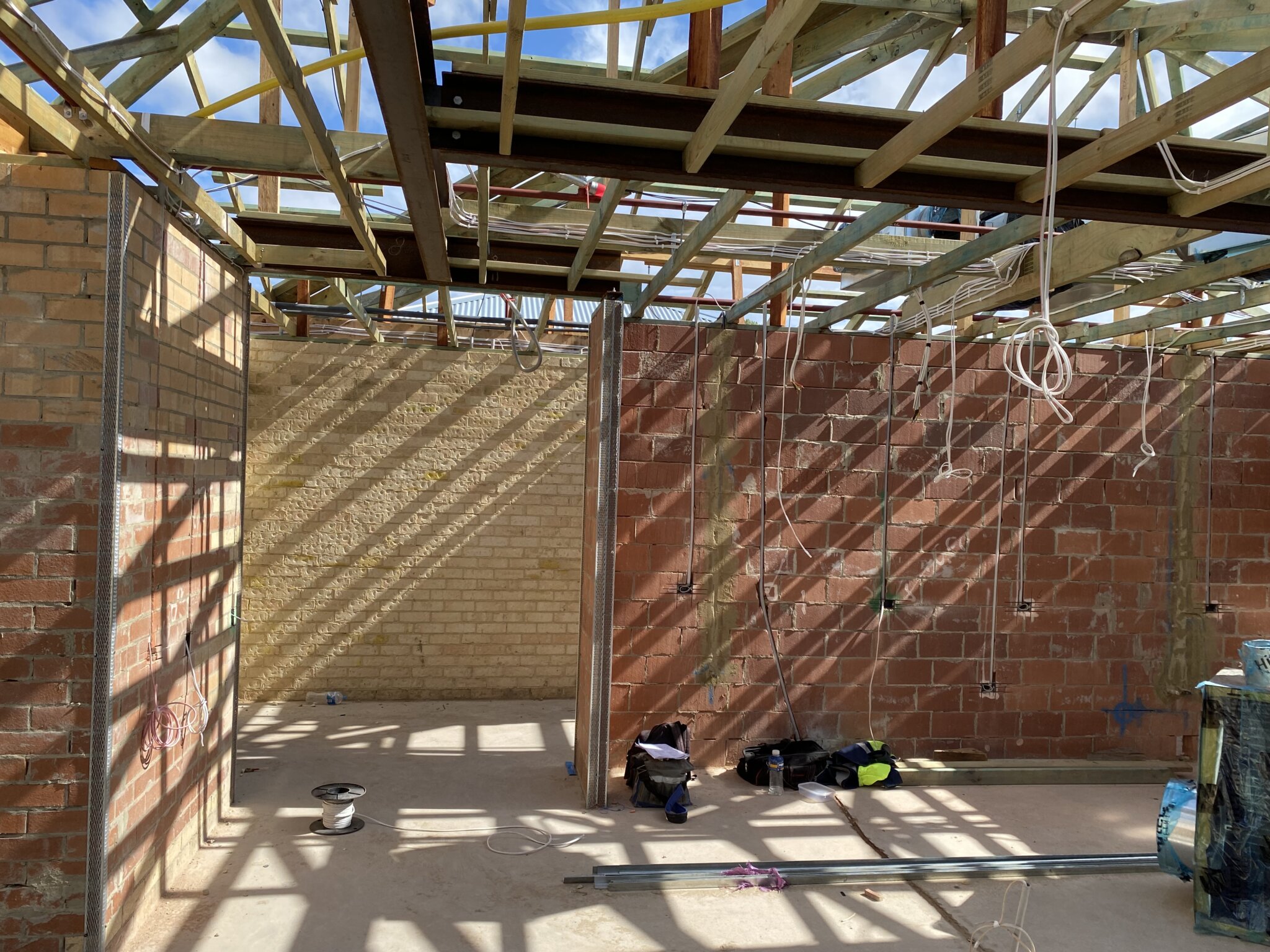

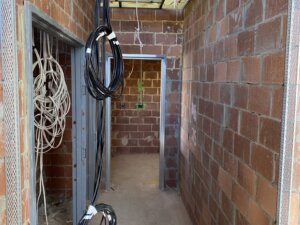

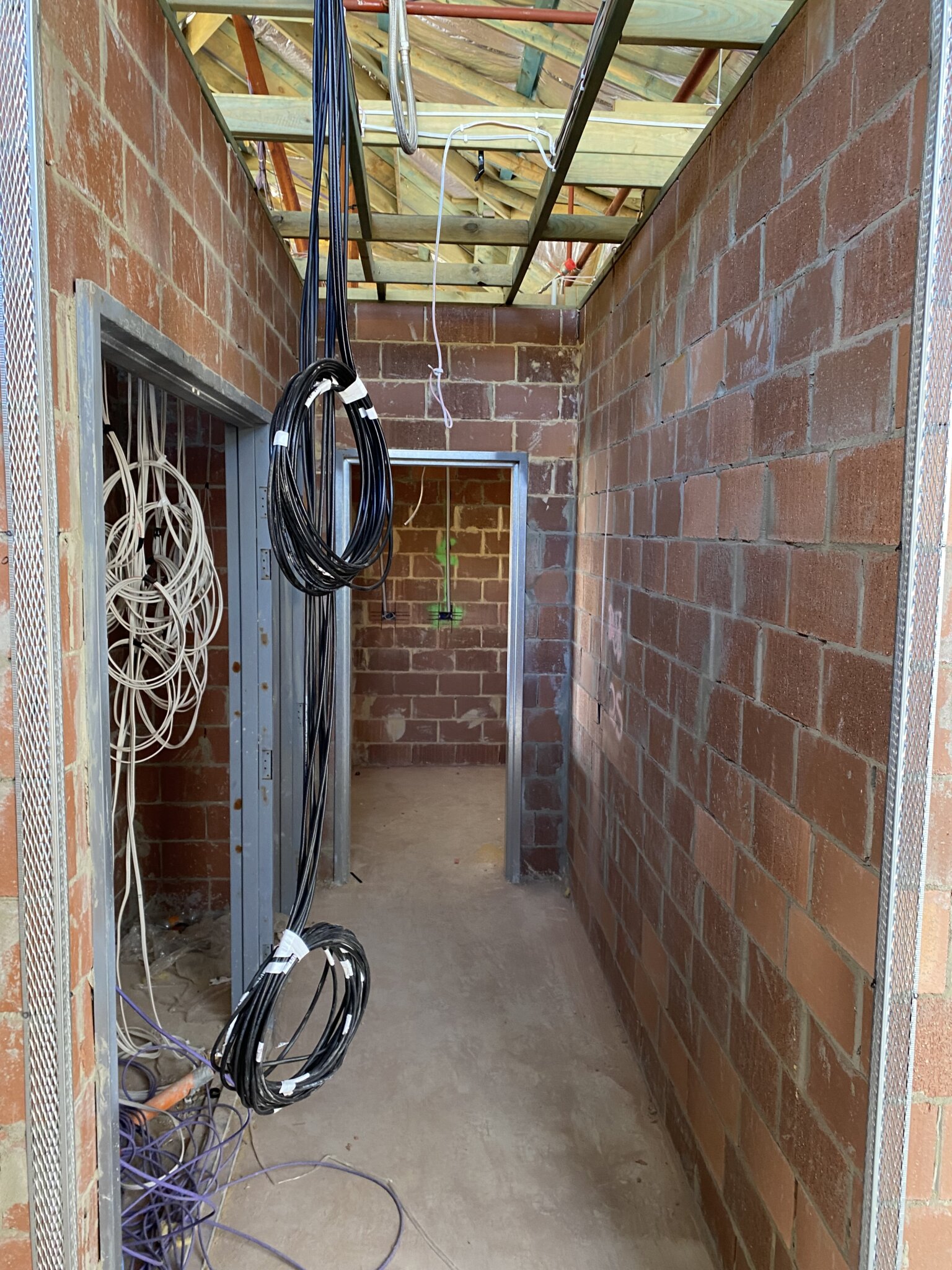

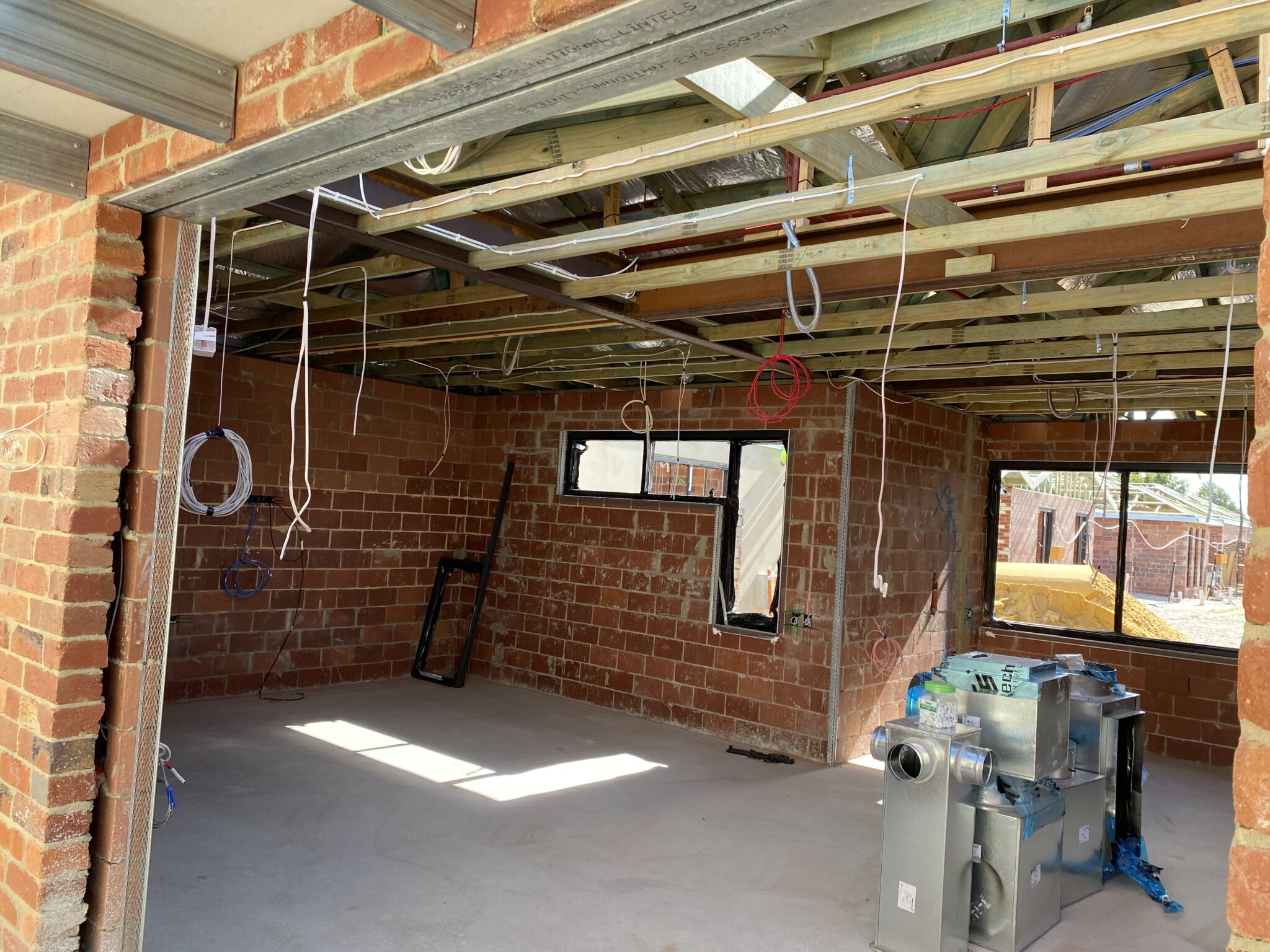

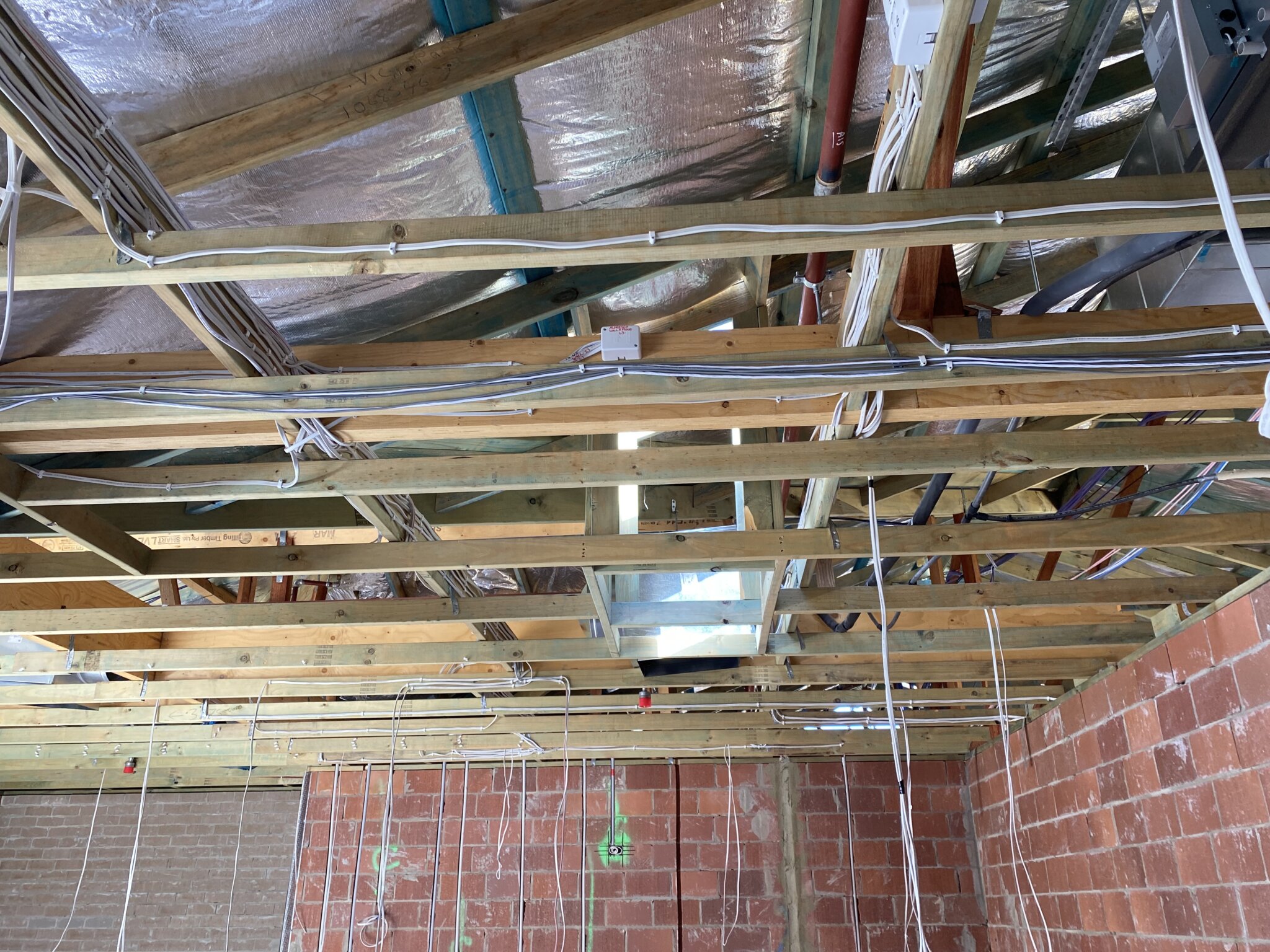

Internally the electricians have commenced running their data and electrical cables. The installation of the pipework for the sprinkler system is also well underway in villas 5 to 8. The mechanical contractor has also commenced installing some of the mechanical services.

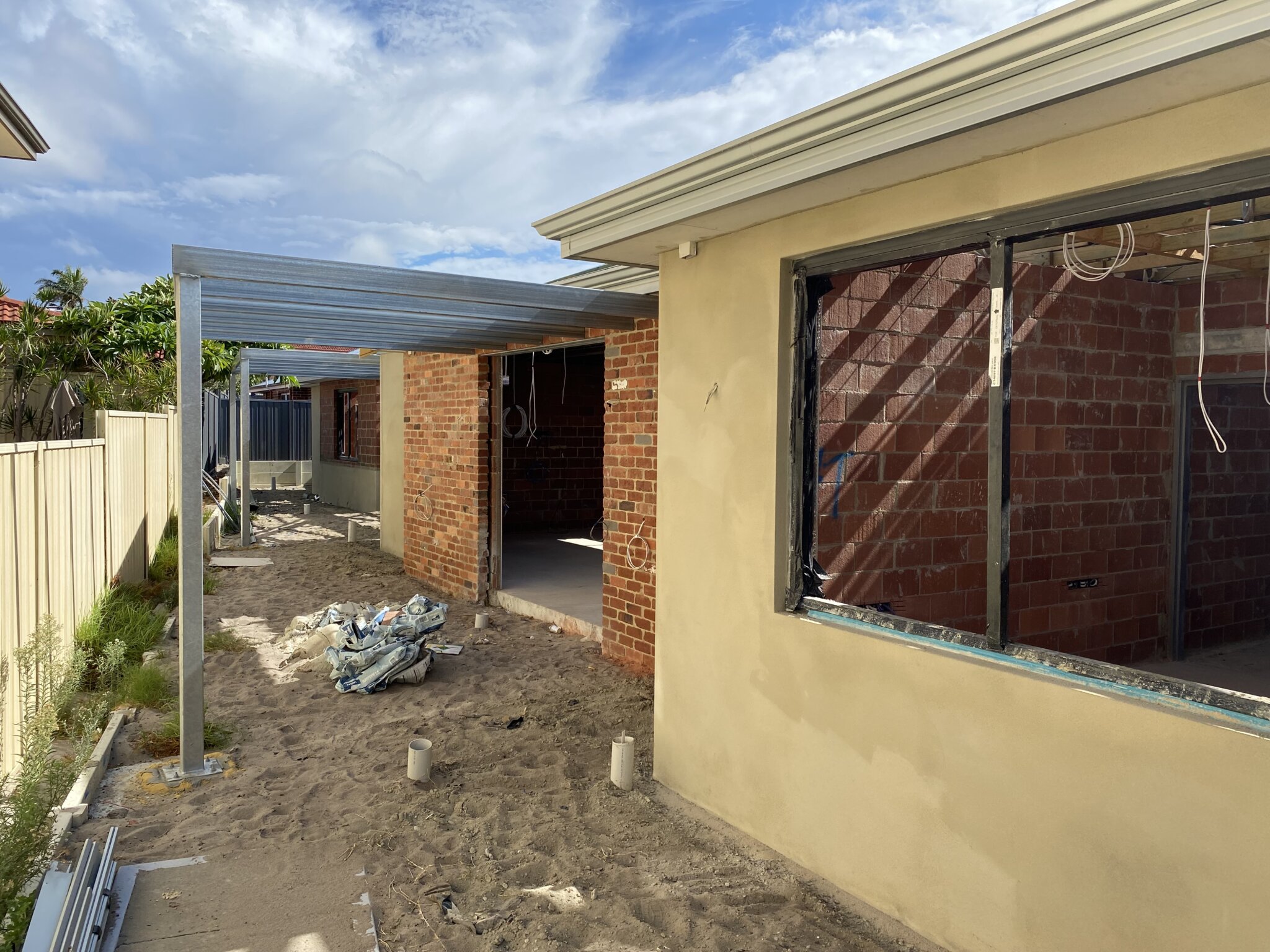

Finally, all of the window frames have now been installed, the rendering of the external brickwork has commenced and all of the metalwork has been erected for the outdoor patios.

The focus next month will be to complete the roof framing for the last two villas, complete the remaining roof sheeting and continue the installation of the services internally.

The builder is still aiming for a mid to late June practical completion date.

I look forward to updating you next month, but in the meantime should you have any queries please feel free to contact me on (08) 6144 0700 or 0451 533 440.

Regards,
Travis McKenzie
